Readiness explorer

See readiness come together

Start at the top of a property and drill down, one level at a time, to a single requirement. At every level you see the state, the reason and the evidence it is built from.

Illustrative properties with sample data. Not customers.

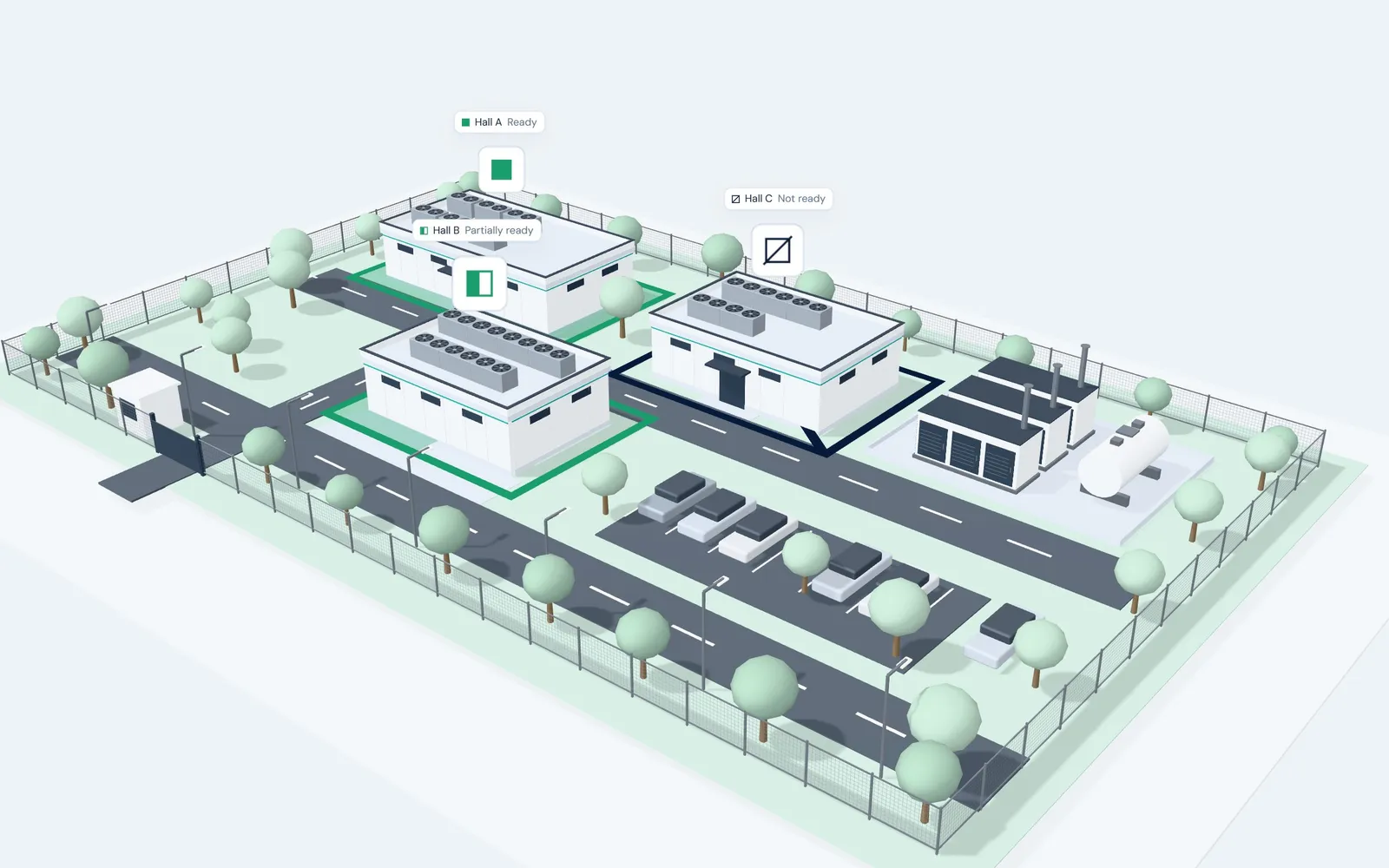

The SuperCore Campus One data center campus in 3D from above, with 3 halls labeled by state: Hall A Ready, Hall B Partially ready and Hall C Not ready.
  • Ready
  • Partially ready
  • Not ready
  • Unknown

  1. 01 / The property

    One campus, one state

    SuperCore Campus One has 3 halls and 60 racks, and it shows one state: partially ready. Hall A is ready and Hall B is partially ready. Hall C is not ready, only because its generator load test is overdue: all 20 of its racks are ready. Every level of the campus carries one state and its reason.

    The SuperCore Campus One data center campus in 3D from above, with 3 halls labeled by state: Hall A Ready, Hall B Partially ready and Hall C Not ready.
  2. 02 / Locations

    Hall B: 16 racks, each with its own state

    Hall B holds 16 racks in four rows. By state: 11 ready, 1 partially ready, 3 not ready, 1 unknown. A hall is a location: it reads its racks, so it stays partially ready until every rack is ready.

    Hall B in 3D from above: 16 racks in four rows, each with a state plate. Labels mark the 5 racks that are not fully ready.
  3. 03 / Nested locations

    Row B2: 4 racks, one of them not ready

    Locations nest: a row sits inside a hall and holds racks. Row B2 has 4 racks and 3 of them are ready, so the row is partially ready. The one that is not ready is Rack B2-02.

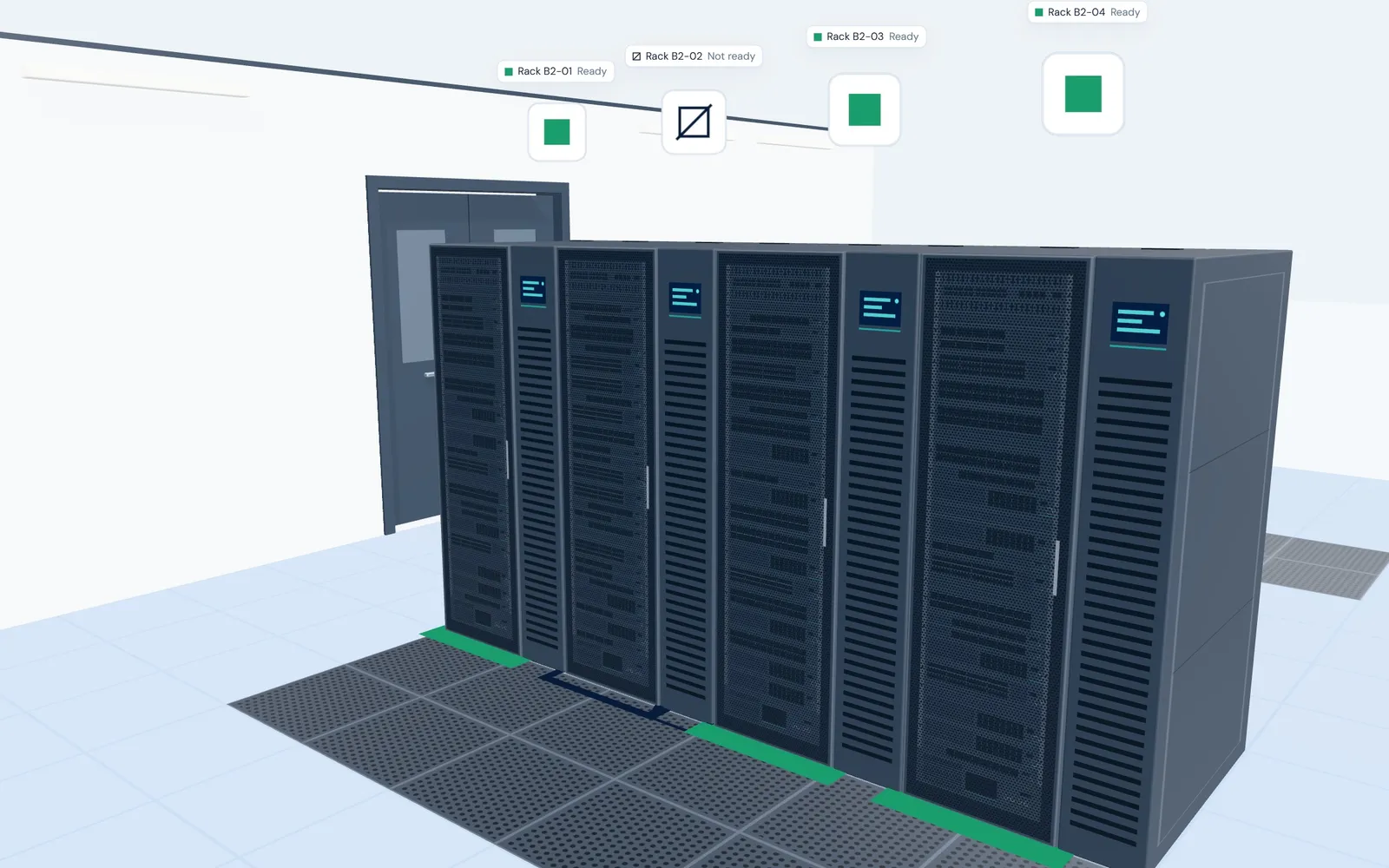

    Row B2 in 3D: 4 racks side by side, each labeled with its state. Rack B2-02 is Not ready and the others are Ready.
  4. 04 / Units

    Rack B2-02 is not ready, and it says why

    A rack is a unit: one rack, one state, one reason. Rack B2-02 is not ready. Reason: Cooling unit CRAC-B2-02 filter service is overdue by 7 days. Next step: Filter service raised to facilities.

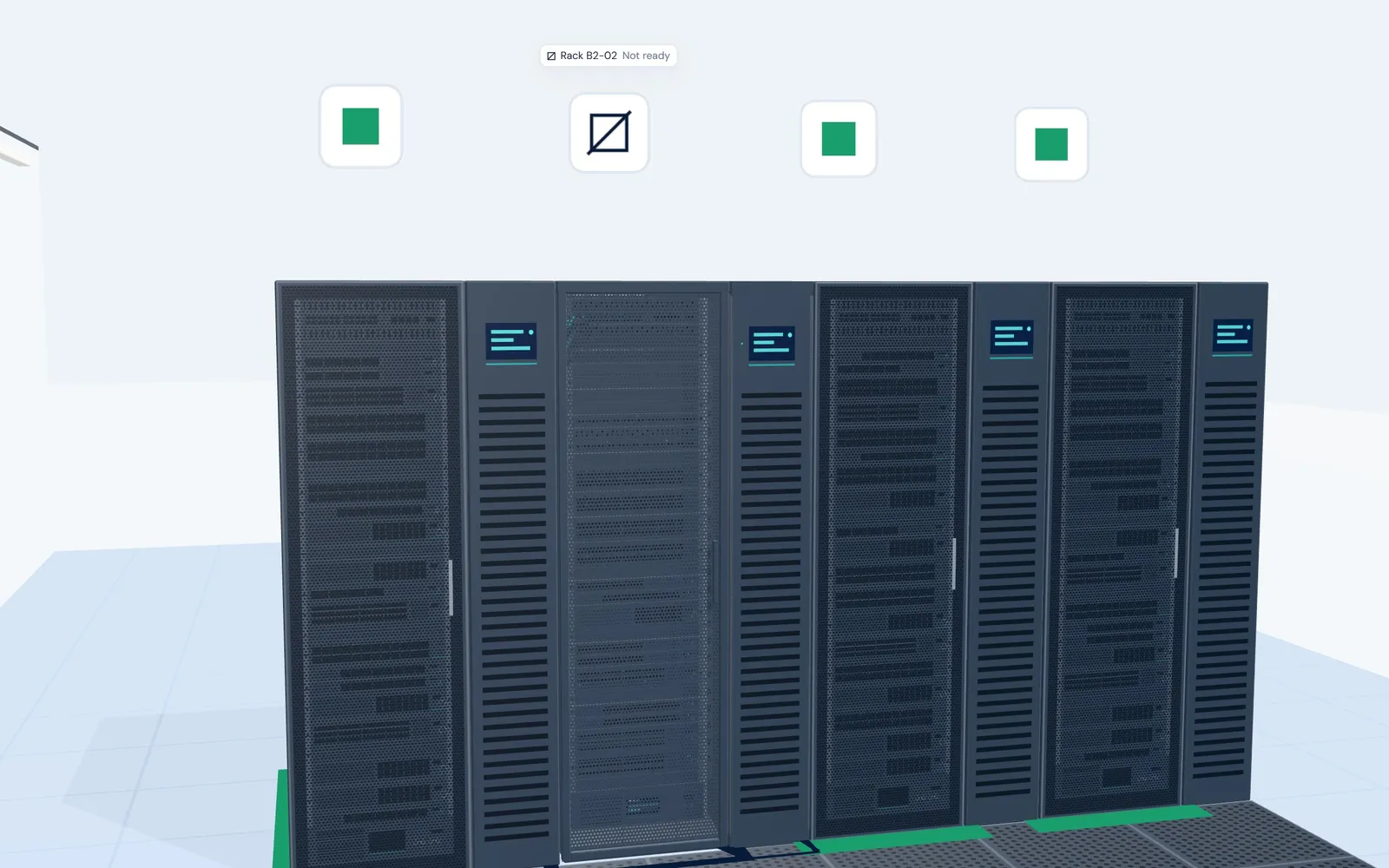

    Rack B2-02 in 3D, closed, with one label marking it Not ready.
  5. 05 / Things

    Open the rack: every thing has its own policy

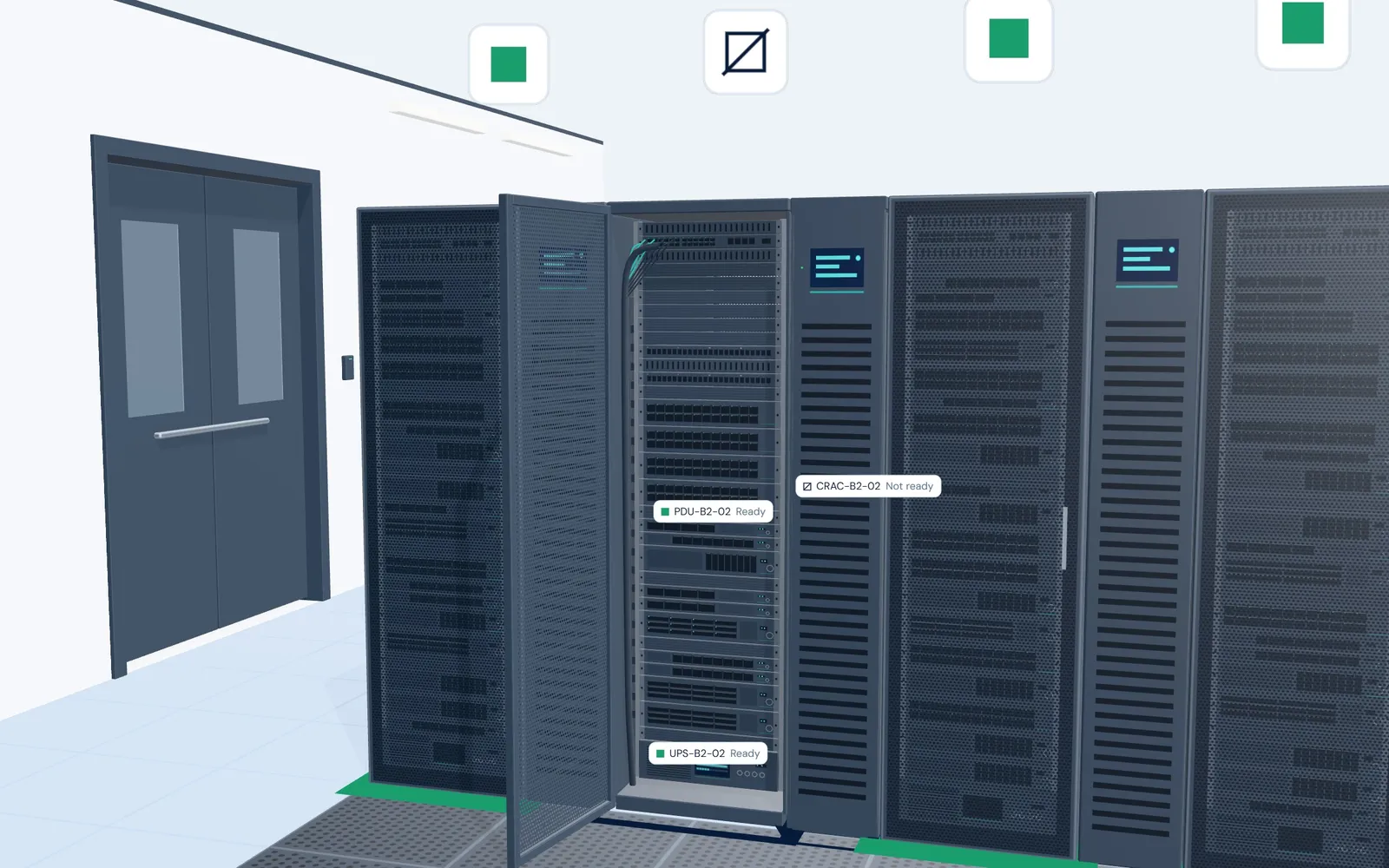

    Open Rack B2-02 and the things inside it appear: 10 servers, a PDU, a UPS and the in-row cooling unit CRAC-B2-02. Each is a thing with its own record and its own readiness policy. A thing can hold things too: a server holds its power supplies, fans and drives.

    Rack B2-02 opened in 3D: 10 servers, a PDU, a UPS and the in-row cooling unit CRAC-B2-02, each with its own label. The cooling unit is marked Not ready and the rest Ready.
  6. 06 / Evidence

    Pull out a server: each part has its result

    Server 05 slides out: two power supplies, the fans and the drives. Each part passed at the last health check. That is evidence: a record the requirement is checked against, here “Health check recorded 18:45, every component passed”. Without such a record, a requirement is unknown, never a pass.

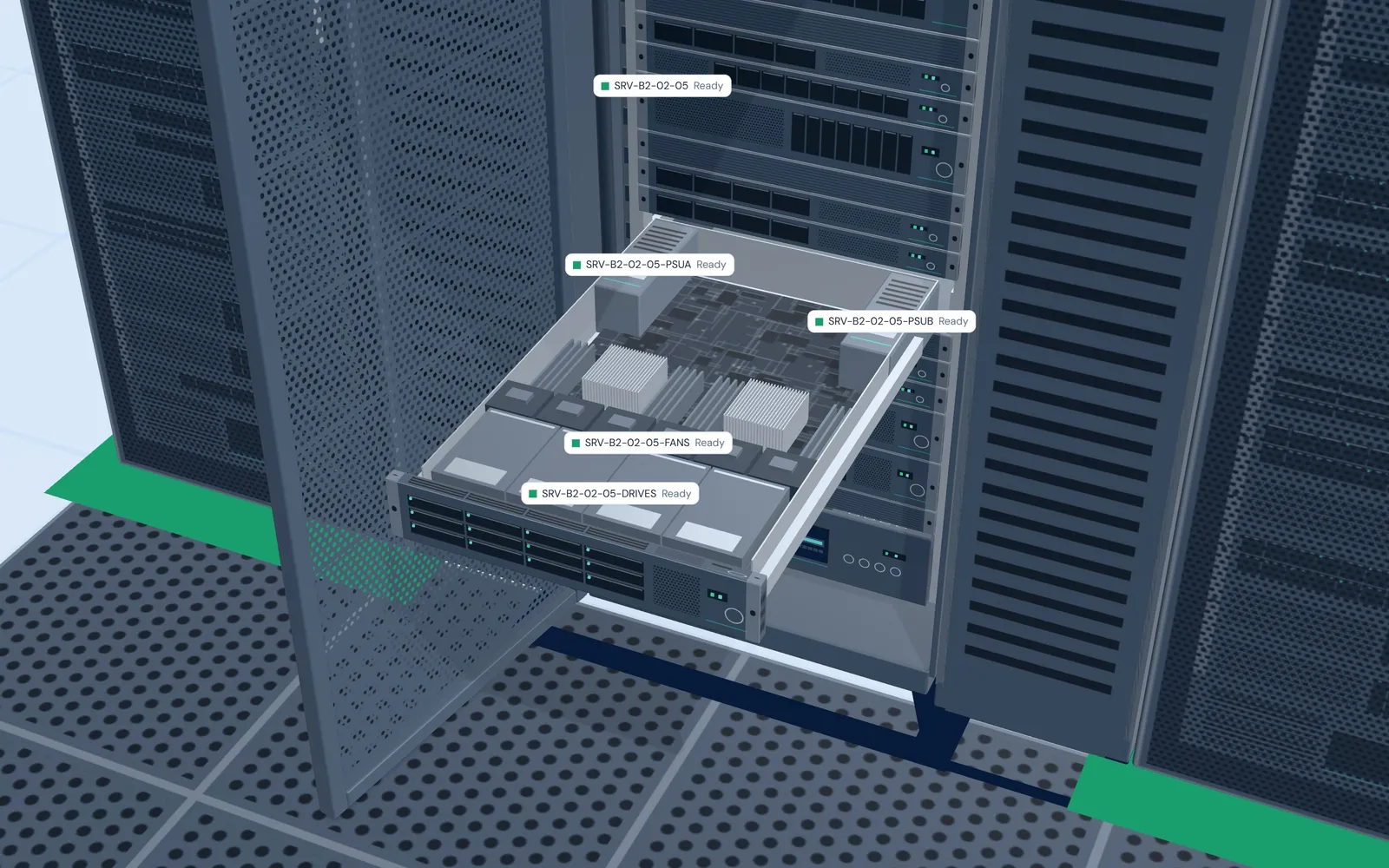

    Server 05 of Rack B2-02 slid out of the rack in 3D, with labels on the server and on its two power supplies, fans and drives, all marked Ready.
  7. 07 / Policy and requirement

    The cooling unit fails one requirement

    Every kind of thing has a readiness policy: the requirements it must meet to be ready. The in-row cooling unit’s policy includes “Filter serviced within 90 days”, severity blocking. The record for CRAC-B2-02 says: Filter serviced 97 days ago, limit 90 (7 days overdue). Severity sets the effect: blocking means not ready, degrading means partially ready, advisory is shown but changes nothing.

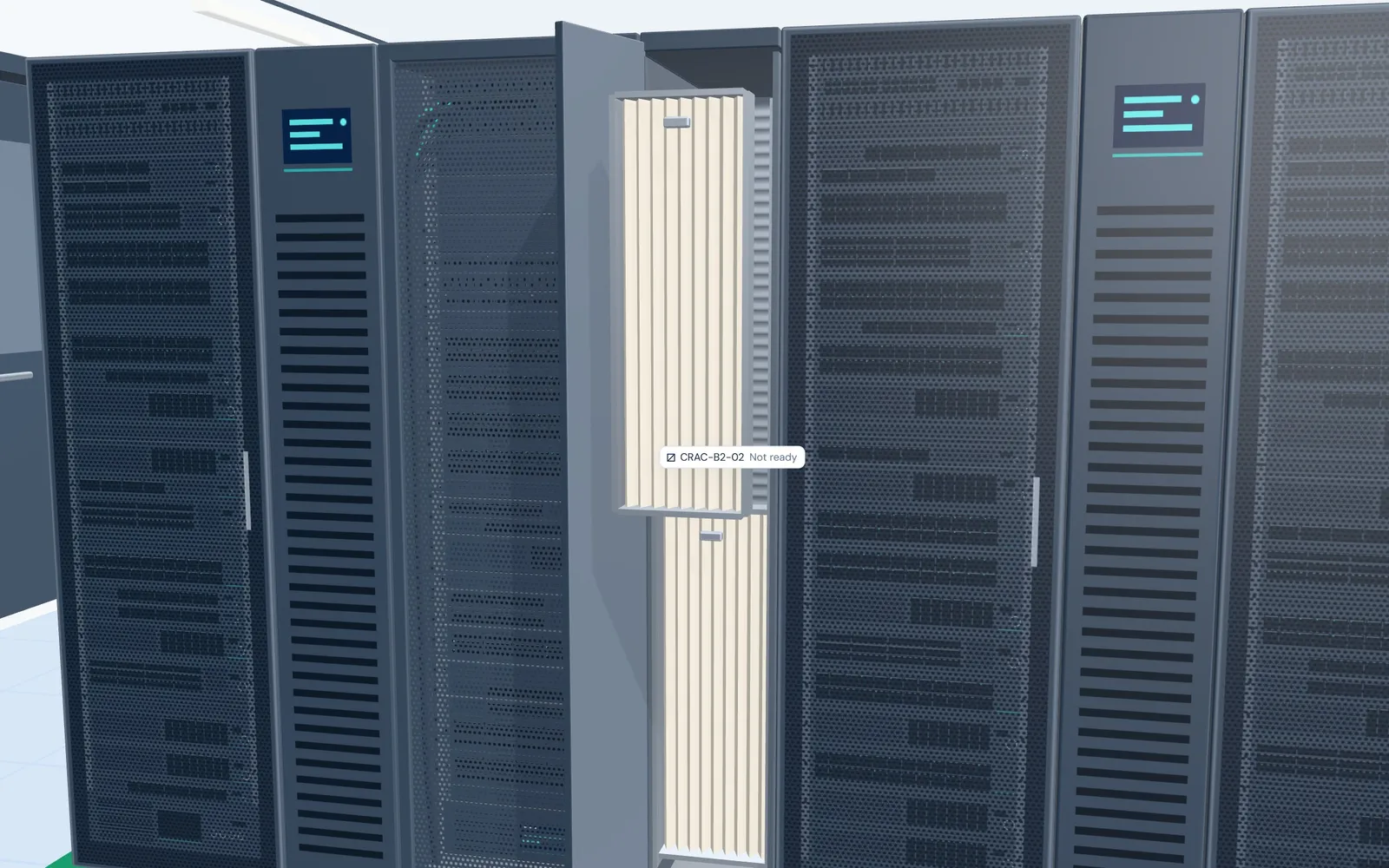

    The in-row cooling unit CRAC-B2-02 in close-up in 3D, with one label marking it Not ready.
  8. 08 / Verdict

    One failed blocking requirement makes the rack not ready

    A verdict follows from the requirements and their severities. The rack’s condition “Rack equipment ready” reads “Rolled up: 3 of 4 assets ready” and is blocking, so Rack B2-02 is not ready. The verdict always travels with its reason, so the next shift reads the same answer.

    In-row cooling unit (CRAC) CRAC-B2-02
    Requirement
    Filter serviced within 90 days Blocking
    Evidence
    Filter serviced 97 days ago, limit 90 (7 days overdue)
    Result
    Failed
    Verdict
    Rack B2-02: Not ready

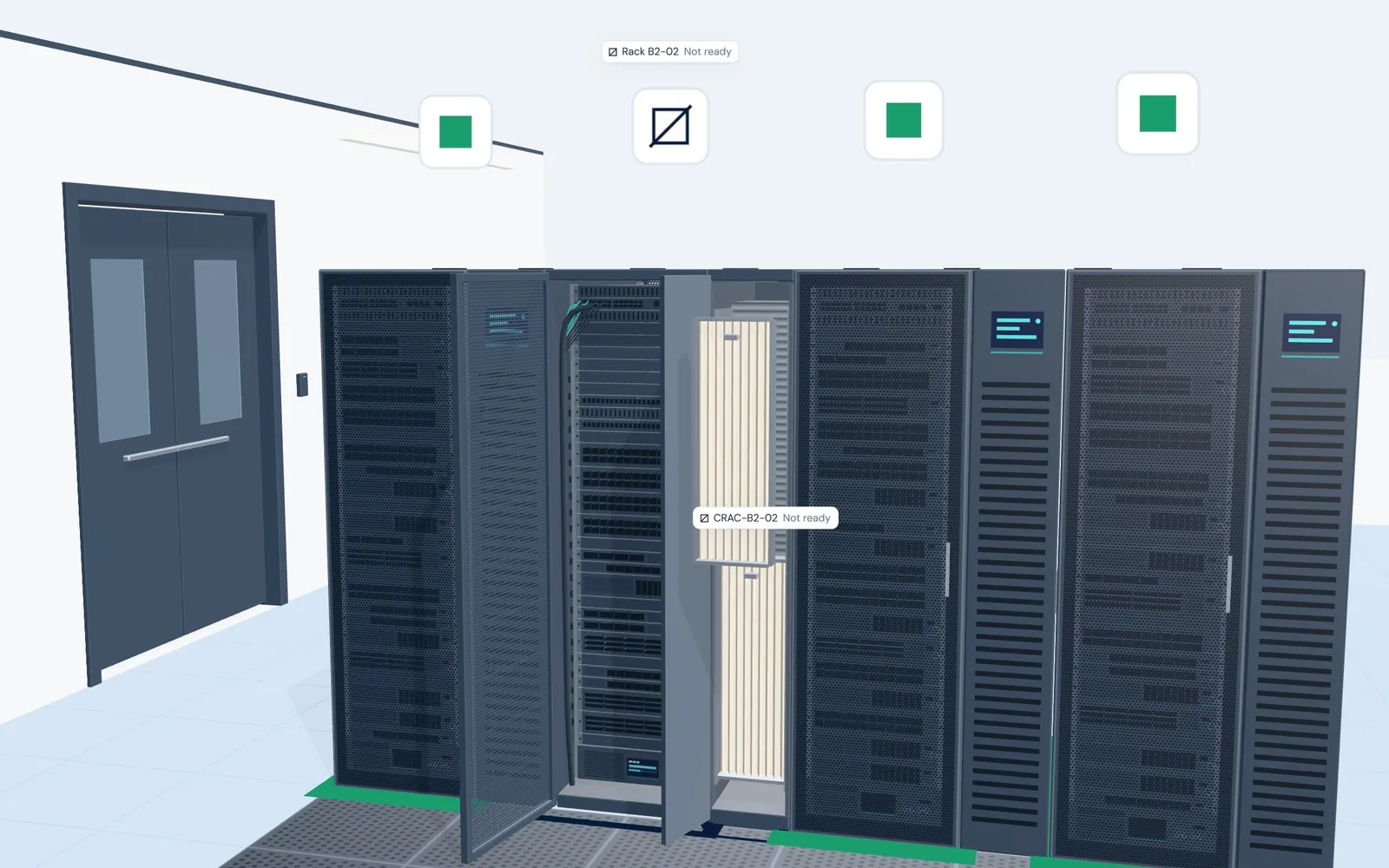

    Rack B2-02 in 3D with its door open and the in-row cooling unit CRAC-B2-02 beside it open, its upper filter pulled out. Labels mark the rack and the cooling unit Not ready.
  9. 09 / The engine

    The engine raises the work and checks again

    The readiness engine keeps the state. At 19:02 it raised the filter service to facilities. The technician recorded the service at 21:15, the check ran again at 21:16, and Rack B2-02 is ready. No one had to remember to check again.

    In-row cooling unit (CRAC) CRAC-B2-02
    Requirement
    Filter serviced within 90 days Blocking
    Evidence
    Filter service recorded 21:15, limit 90
    Result
    Met
    Verdict
    Rack B2-02: Ready

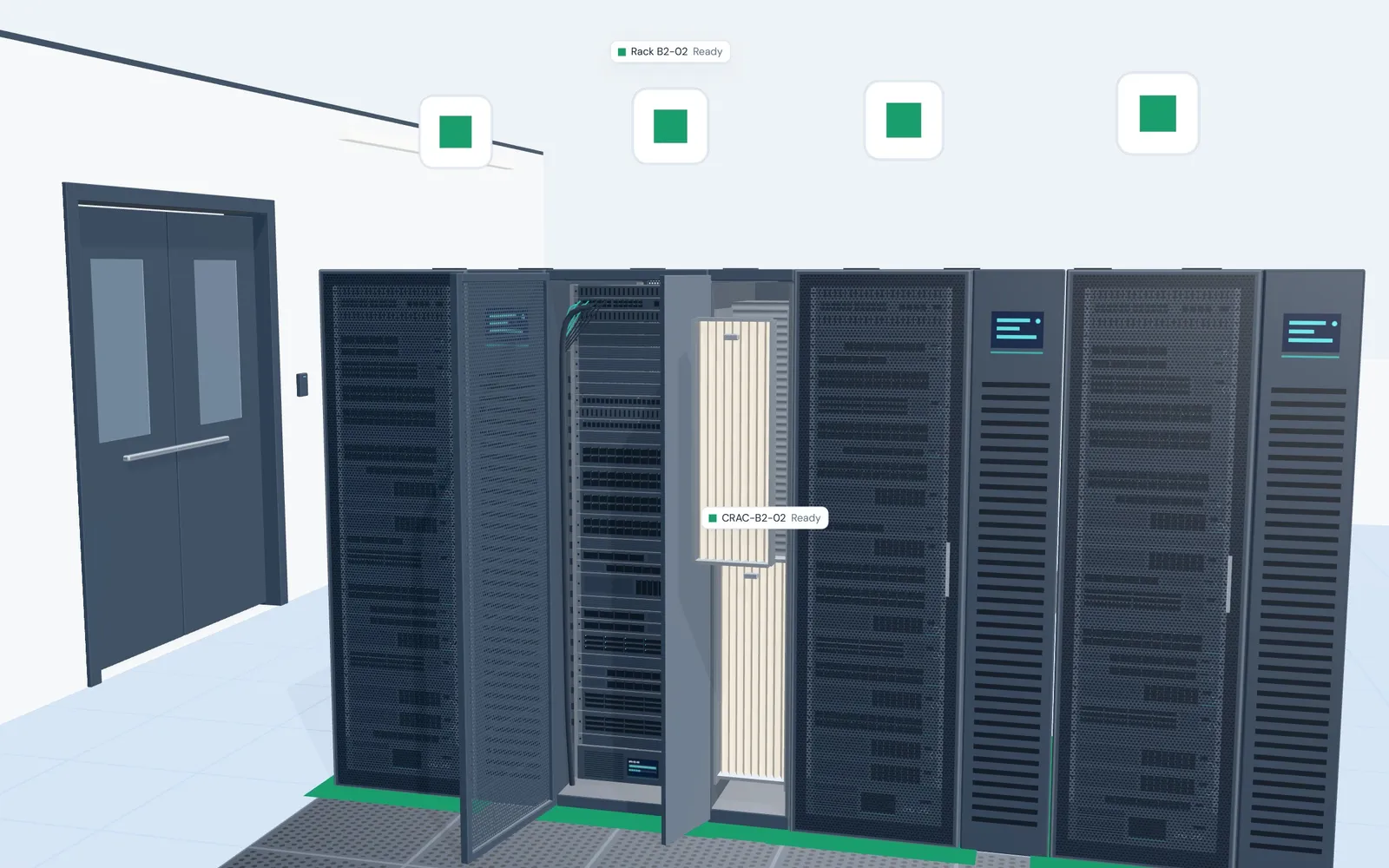

    Rack B2-02 and its cooling unit CRAC-B2-02 in 3D after the check ran again, both labeled Ready.
  10. 10 / Roll-up

    Readiness rolls up

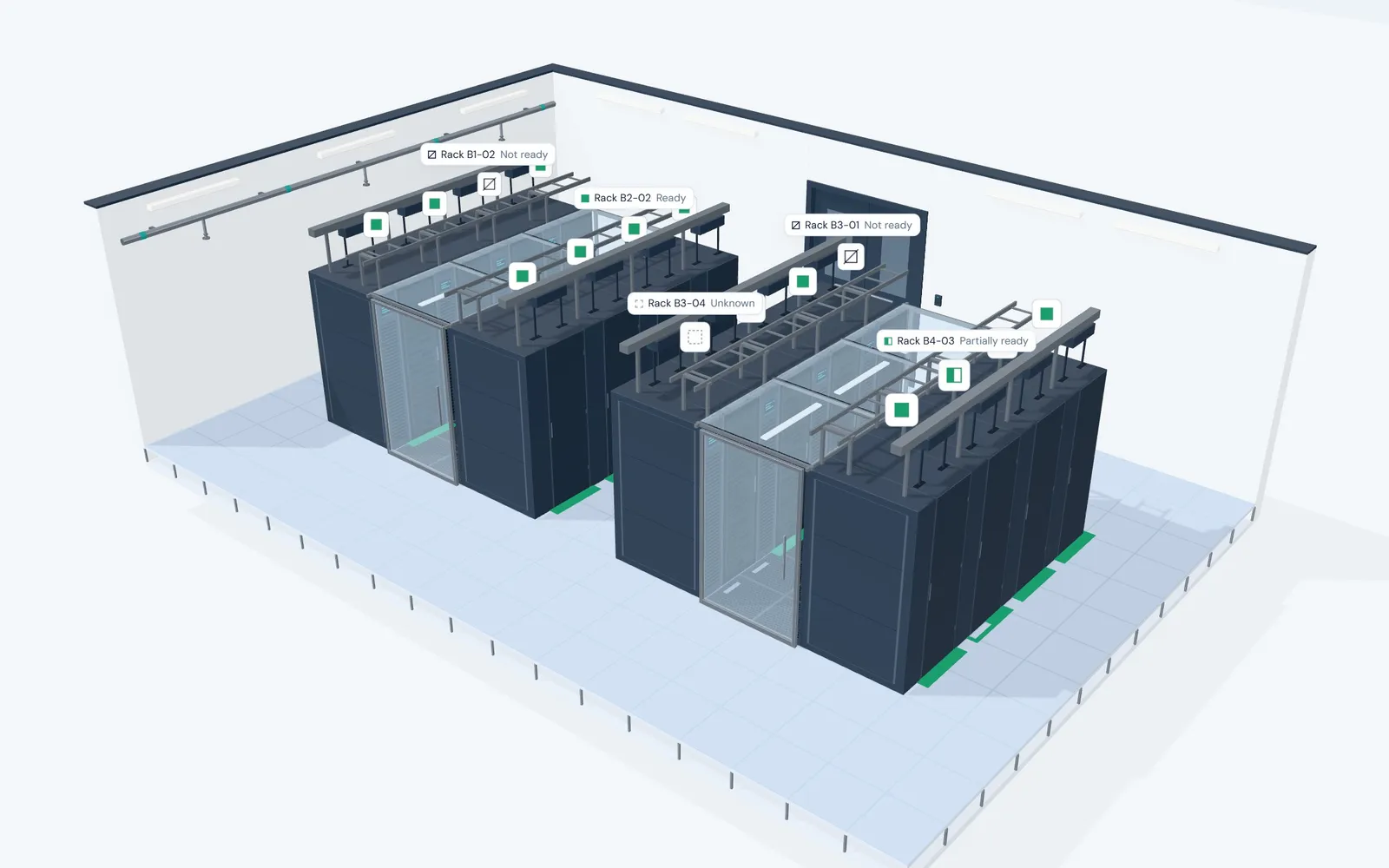

    Rack B2-02 is ready. Row B2 now reads 4 of 4 racks ready, so the row is ready. Hall B reads 12 of 16 and stays partially ready, because racks B1-02, B3-01, B3-04 and B4-03 are still open. Each level reads the one below it, so there is nothing to add up by hand.

    Hall B in 3D after the check ran again, with labels on the 5 racks that were not fully ready. Rack B2-02 now reads Ready, and Rack B1-02, Rack B3-01, Rack B3-04 and Rack B4-03 still show their open states.
  11. 11 / Unknown

    Unknown is never a pass

    Rack B3-04 has no inspection record for its PDU, and that requirement is blocking. With no evidence the answer is unknown, never a pass, so the rack reads unknown too. Next step: Evidence needs review. No task created.

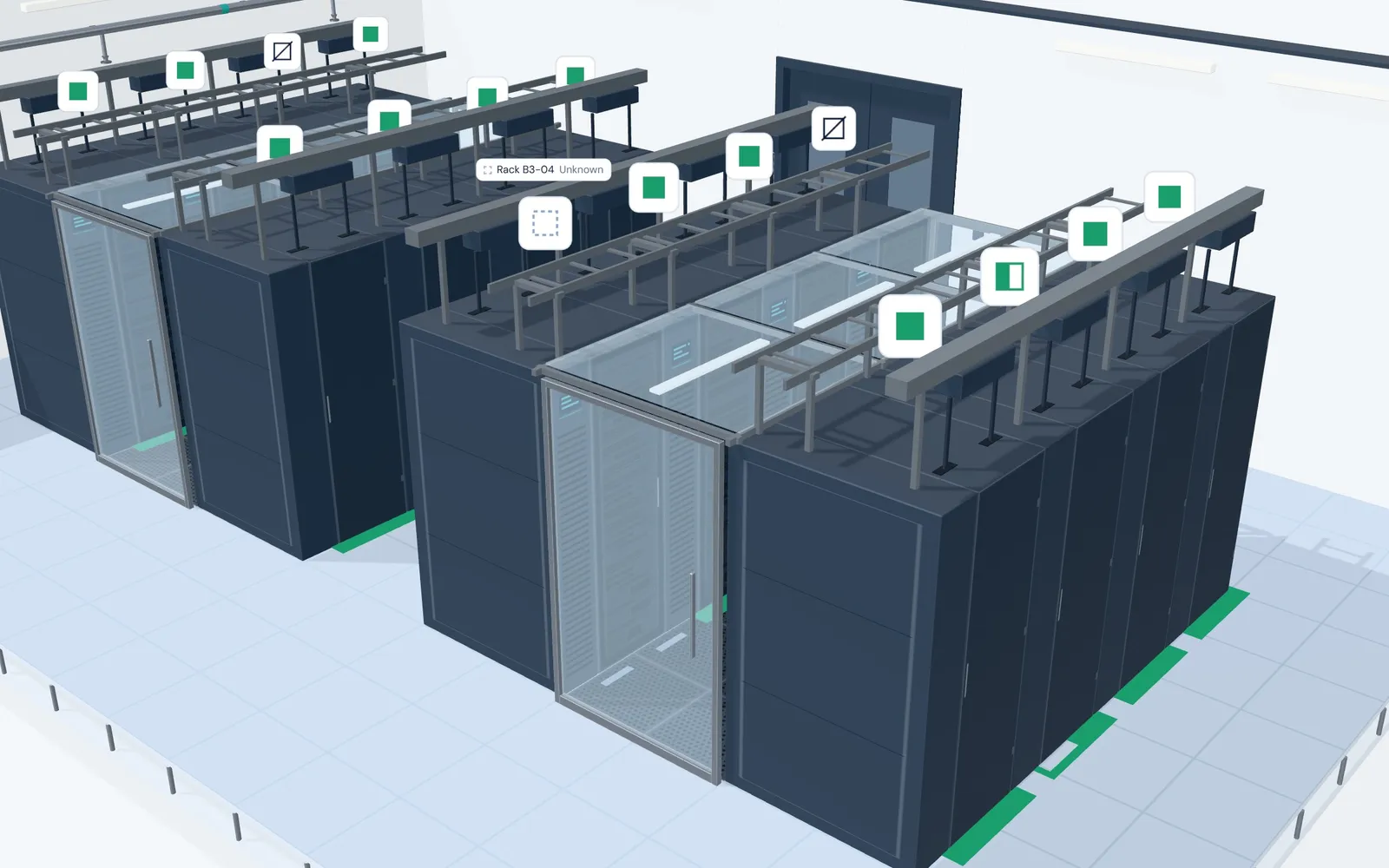

    Row B3 of Hall B in 3D, seen down the cold aisle, with one label on Rack B3-04 marked Unknown.
  12. 12 / Partially ready

    Partially ready: a degrading requirement failed

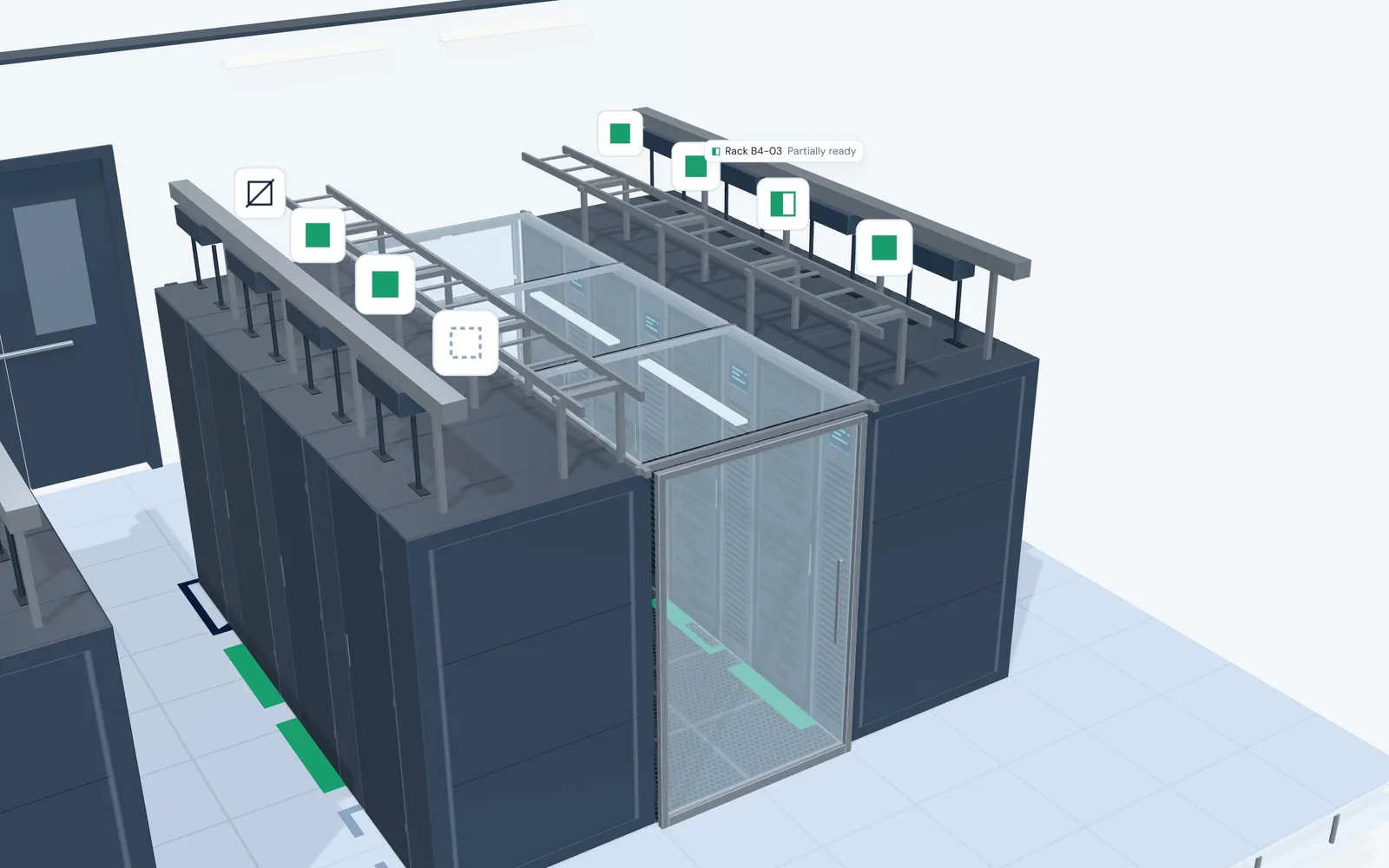

    Rack B4-03 runs above its safe band: the inlet temperature record reads “28.1 °C, safe band 18 to 27 °C”. That requirement is degrading, not blocking, so the rack is partially ready instead of not ready. Next step: Re-checked at the next reading, no work configured.

    Row B4 of Hall B in 3D, seen down the cold aisle, with one label on Rack B4-03 marked Partially ready.
  13. 13 / Summary

    A long standard becomes one state

    Hall B alone has 912 requirements to meet, across 16 racks, 160 servers and their parts. You do not read them. You read one state per level, with its reason, and open the evidence only when you need it. The standard is written once and shared by every team.

    Now see your own property

    Pick one room type, rack row or vehicle group. We map it from the records you already have and show you its readiness live. Free, no commitment.

    Get a free readiness snapshot Take the other tour

    The whole SuperCore Campus One in 3D from above after the check ran again, with each hall labeled by its state.
  1. 01 / The property

    One property, one state

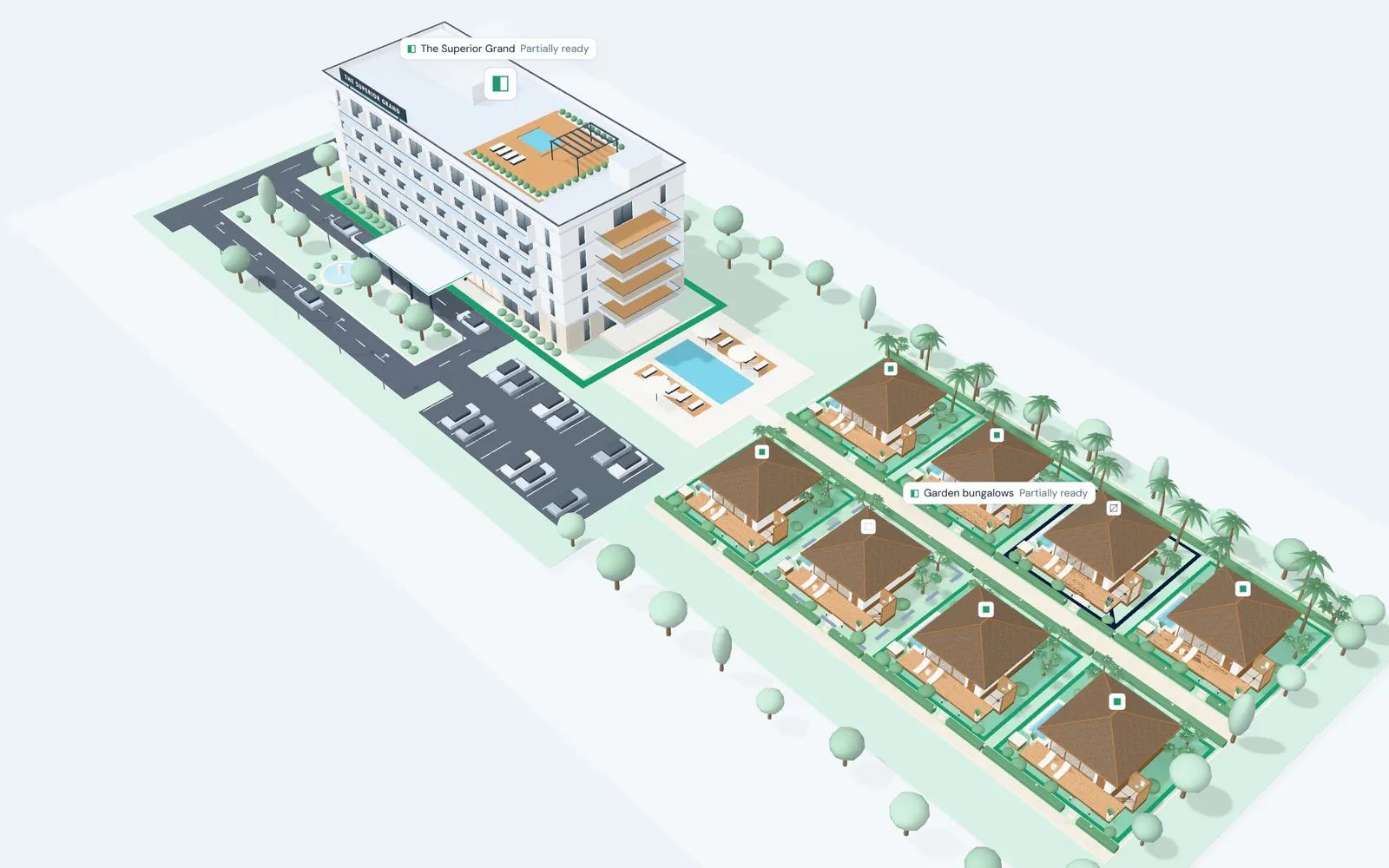

    The Superior Grand is a fictional hotel with 5 floors, 84 rooms and 8 garden bungalows. As a whole it is partially ready. That state is not entered by hand: it is built from the evidence underneath, level by level. Start at the top, then go down to one requirement.

    The Superior Grand in 3D from above: a 5-floor hotel building with its 8 garden bungalows in the grounds.
  2. 02 / Locations

    Pull the floors apart

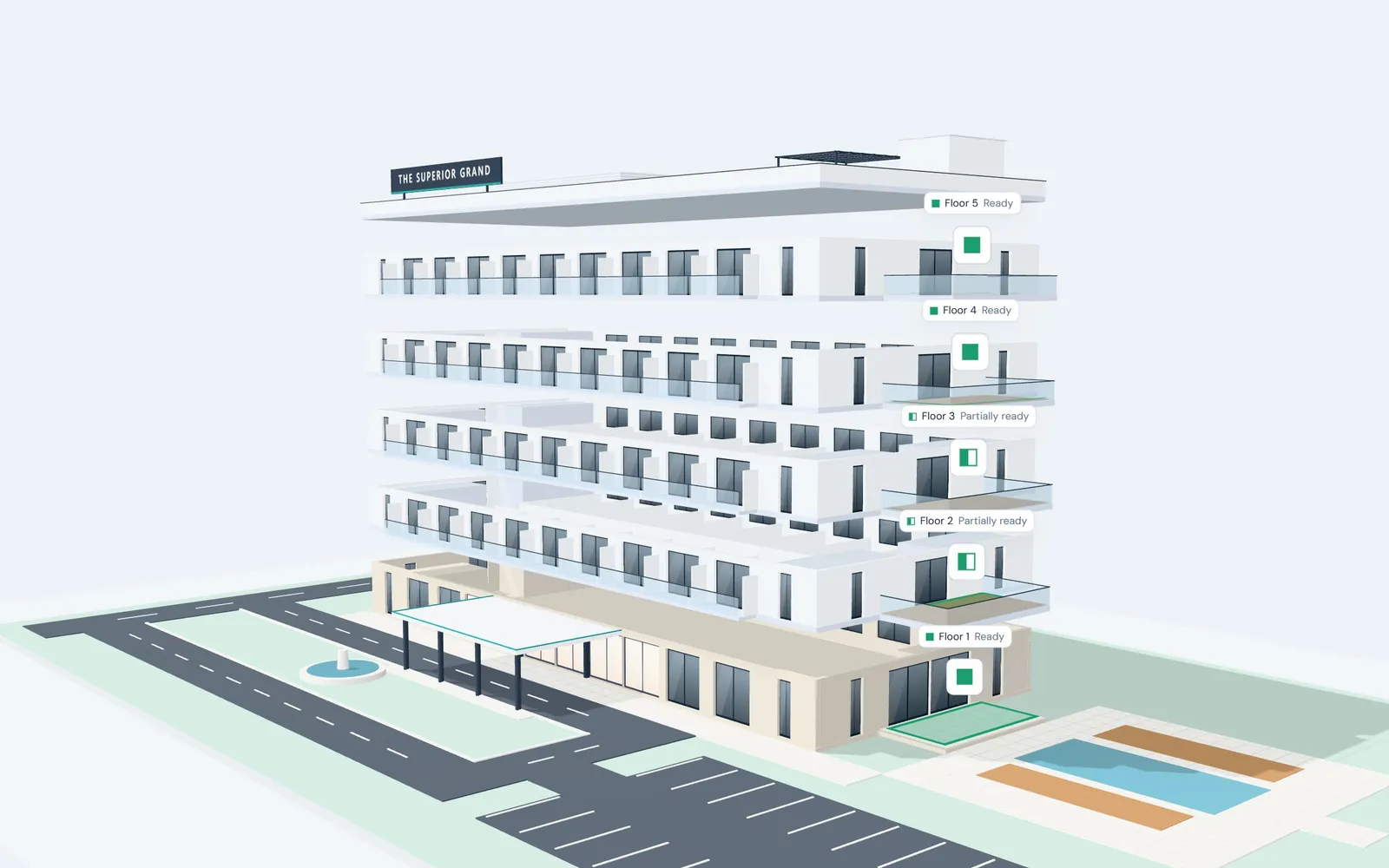

    Each floor can be read on its own. Rooms ready: 14 of 14 on Floor 1, 13 of 18 on Floor 2, 17 of 18 on Floor 3, 18 of 18 on Floor 4 and 16 of 16 on Floor 5. A floor is a location: it reads its rooms, so Floor 2 is partially ready while 5 of its 18 rooms are not fully ready.

    The 5 floors of The Superior Grand pulled apart in 3D, each labeled with its state. Floor 1, Floor 4 and Floor 5 are Ready, and Floor 2 and Floor 3 are Partially ready.
  3. 03 / Units

    Floor 2: 18 rooms, each with its own state

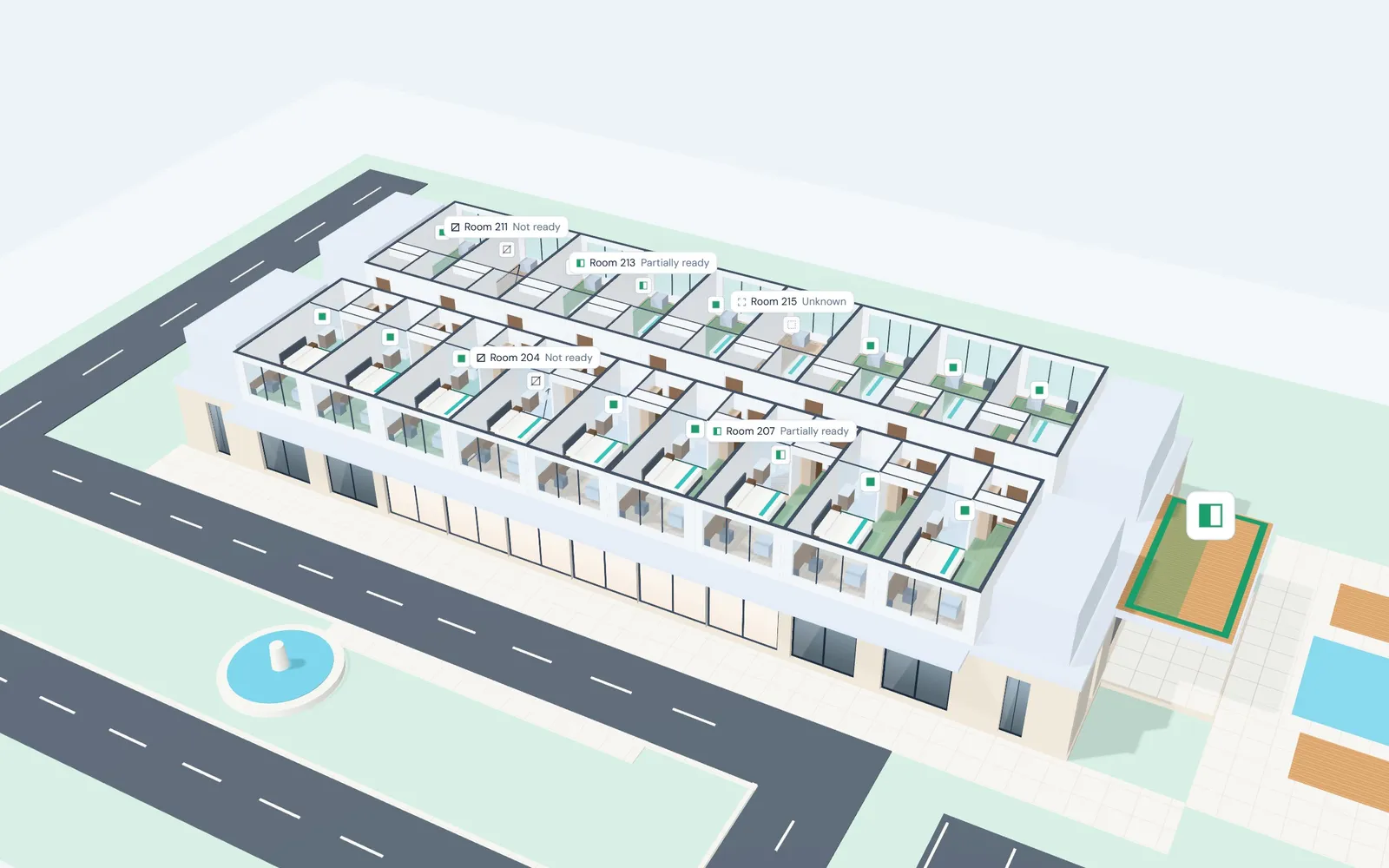

    Floor 2 holds rooms 201 to 218, and each room is a unit with its own state. By state: 13 ready, 2 partially ready, 2 not ready, 1 unknown. Rooms 204, 207, 211, 213 and 215 are the ones worth a conversation at 07:00.

    Floor 2 of The Superior Grand in 3D from above: rooms 201 to 218, each with a state plate. Labels mark the 5 rooms that are not fully ready.
  4. 04 / Things

    Inside Room 204, every thing has its own record

    Room 204 is a unit, and inside it are 5 things: air handler AHU-204, minibar MB-204, door lock LK-204, in-room safe SF-204 and bathroom fixtures BF-204. Each thing has its own record and its own readiness policy. The room does not repeat their rules. It reads their verdicts.

    Room 204 in 3D with its 5 things labeled. Air handler AHU-204 is marked Not ready, and the minibar, door lock, in-room safe and bathroom fixtures are marked Ready.
  5. 05 / Readiness policy

    One policy for every room of this type

    Every room of this type follows one readiness policy, written once: Guest-ready room. It has 5 requirements (4 blocking, 1 degrading): turned since last checkout, inspection after cleaning recorded, no open repair, room temperature within the safe band and in-room equipment ready. Blocking means the room cannot be ready while the requirement fails. Housekeeping, maintenance and outside vendors all work toward the same list.

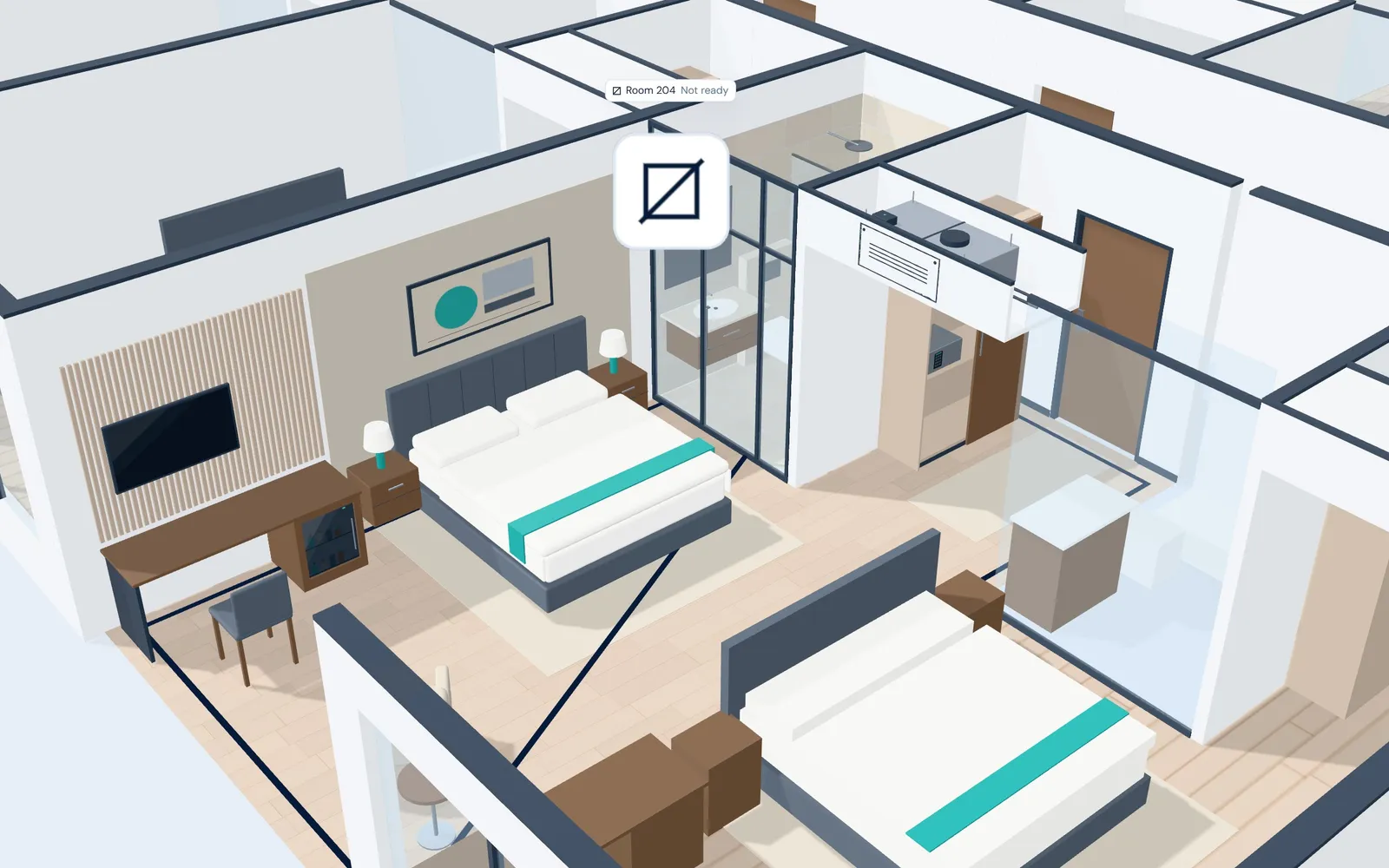

    Room 204 in 3D with one label for the room, marked Not ready.
  6. 06 / Requirement

    The air handler fails its requirement

    The air handler has a policy of its own. Its requirement is “Serviced within 90 days”, severity blocking. The record for AHU-204 says: Serviced 94 days ago, limit 90 (4 days overdue). The requirement fails, and because it is blocking, Room 204 cannot be ready.

    Air handler AHU-204
    Requirement
    Serviced within 90 days Blocking
    Evidence
    Serviced 94 days ago, limit 90 (4 days overdue)
    Result
    Failed
    Verdict
    Room 204: Not ready

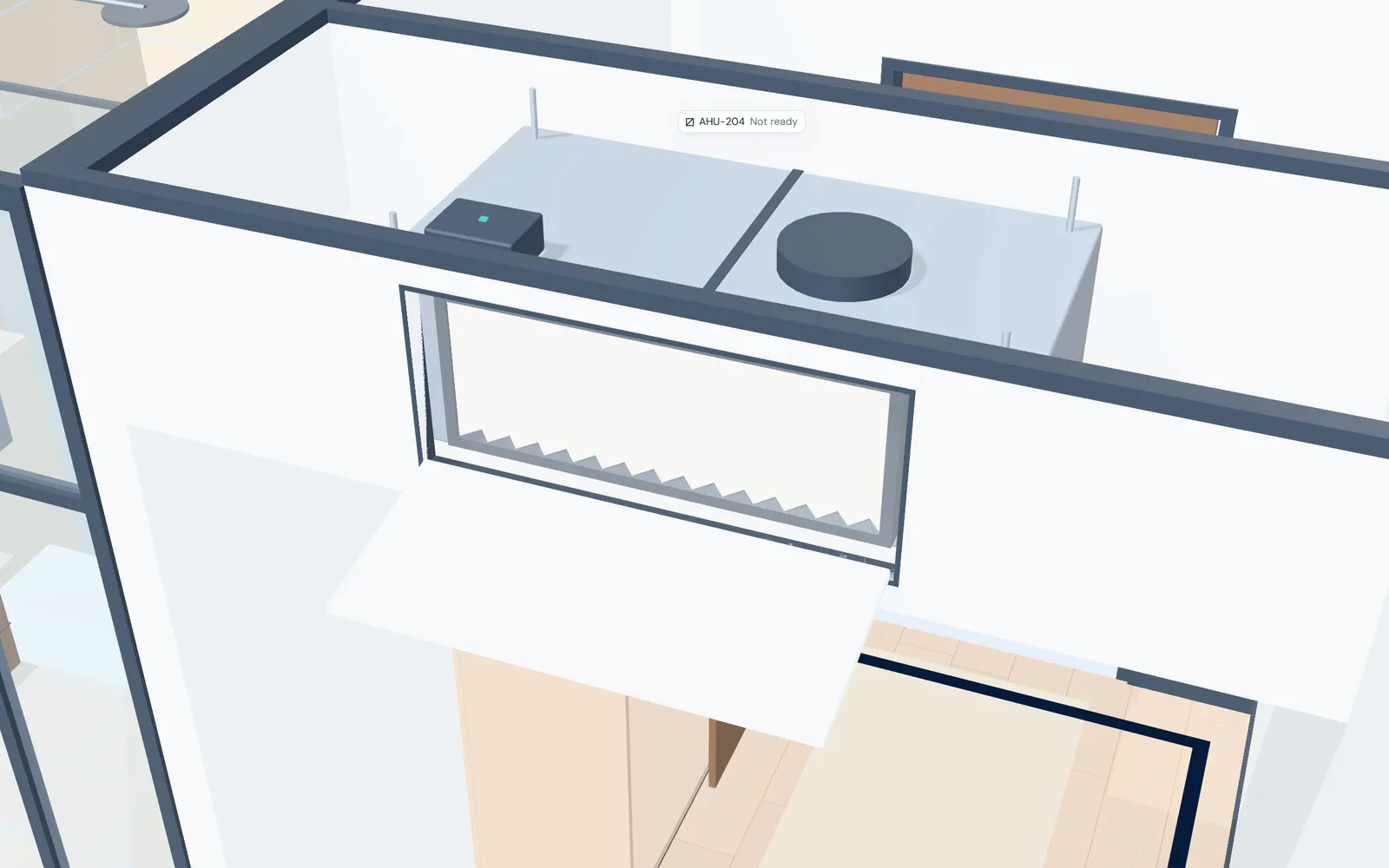

    Air handler AHU-204 in close-up in 3D, with one label marking it Not ready.
  7. 07 / Verdict and engine

    From not ready to ready, without a phone call

    Room 204 was not ready. Reason: Air handler AHU-204 service is overdue by 4 days. The readiness engine raised the service to maintenance at 07:02, the technician recorded it at 09:40, and the check ran again at 09:41. Room 204 is ready, and no one chased it by phone.

    Air handler AHU-204
    Requirement
    Serviced within 90 days Blocking
    Evidence
    Service recorded 09:40, limit 90
    Result
    Met
    Verdict
    Room 204: Ready

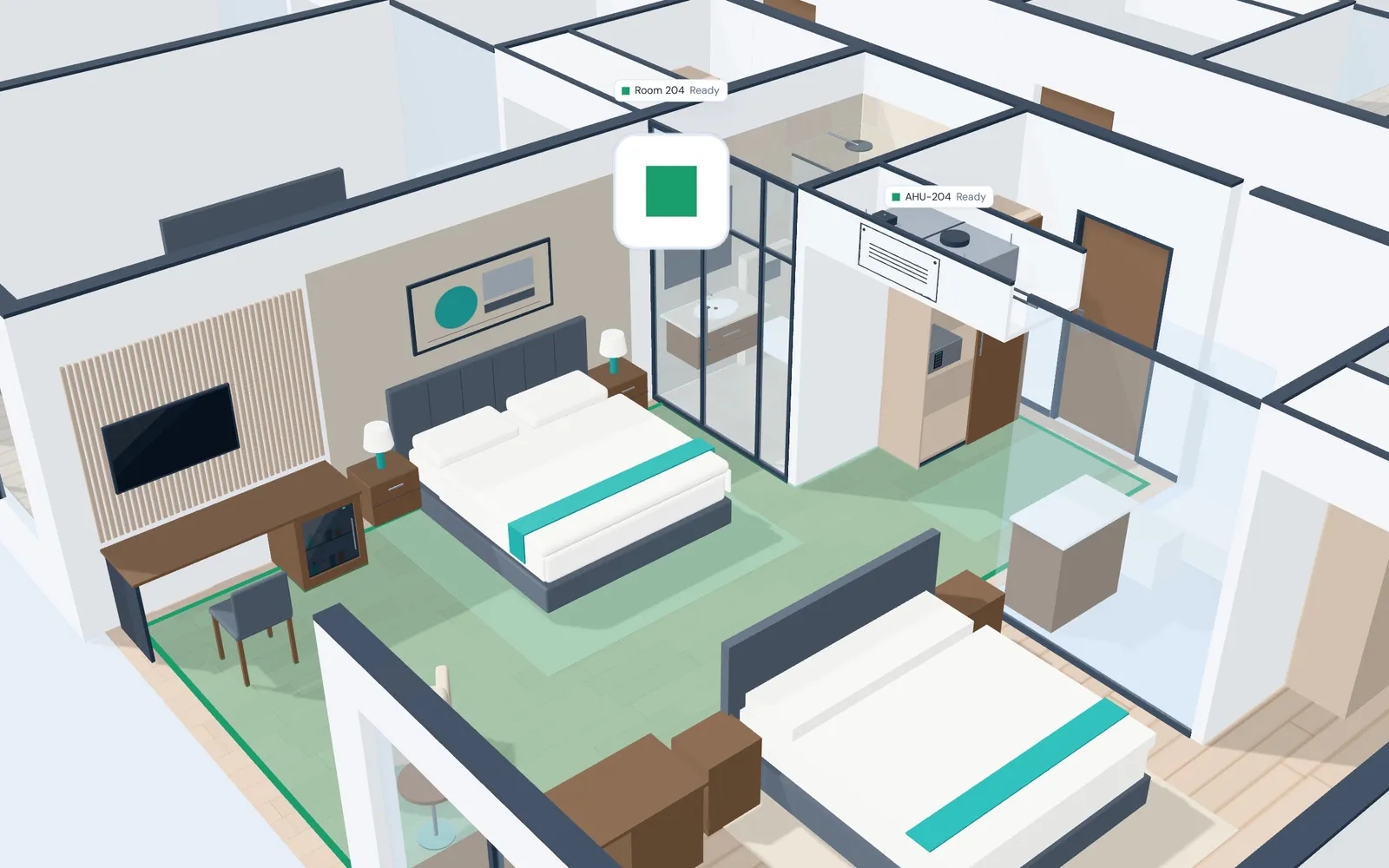

    Room 204 in 3D after the check ran again, with the room and its air handler AHU-204 both marked Ready.
  8. 08 / Roll-up

    The state rolls up to the floor and the property

    With Room 204 ready, Floor 2 now reads 14 of 18 rooms ready. It stays partially ready, because rooms 207, 211, 213 and 215 are not fully ready. The property reads its floors and its garden, so The Superior Grand is partially ready too. Nobody counted by hand.

    Floor 2 in 3D after the check ran again: Room 204 is now marked Ready, while rooms 207, 211, 213 and 215 keep their open states.
  9. 09 / The same model, outside

    The garden bungalows follow the same model

    Outside the main building, 8 garden bungalows are modeled the same way. Each is a unit with things of its own: air handler, minibar, door lock, plunge pool pump and outdoor shower. Their policy is Guest-ready bungalow, which builds on the room policy and adds one requirement: plunge pool water tested today. By state: 6 ready, 1 not ready, 1 unknown.

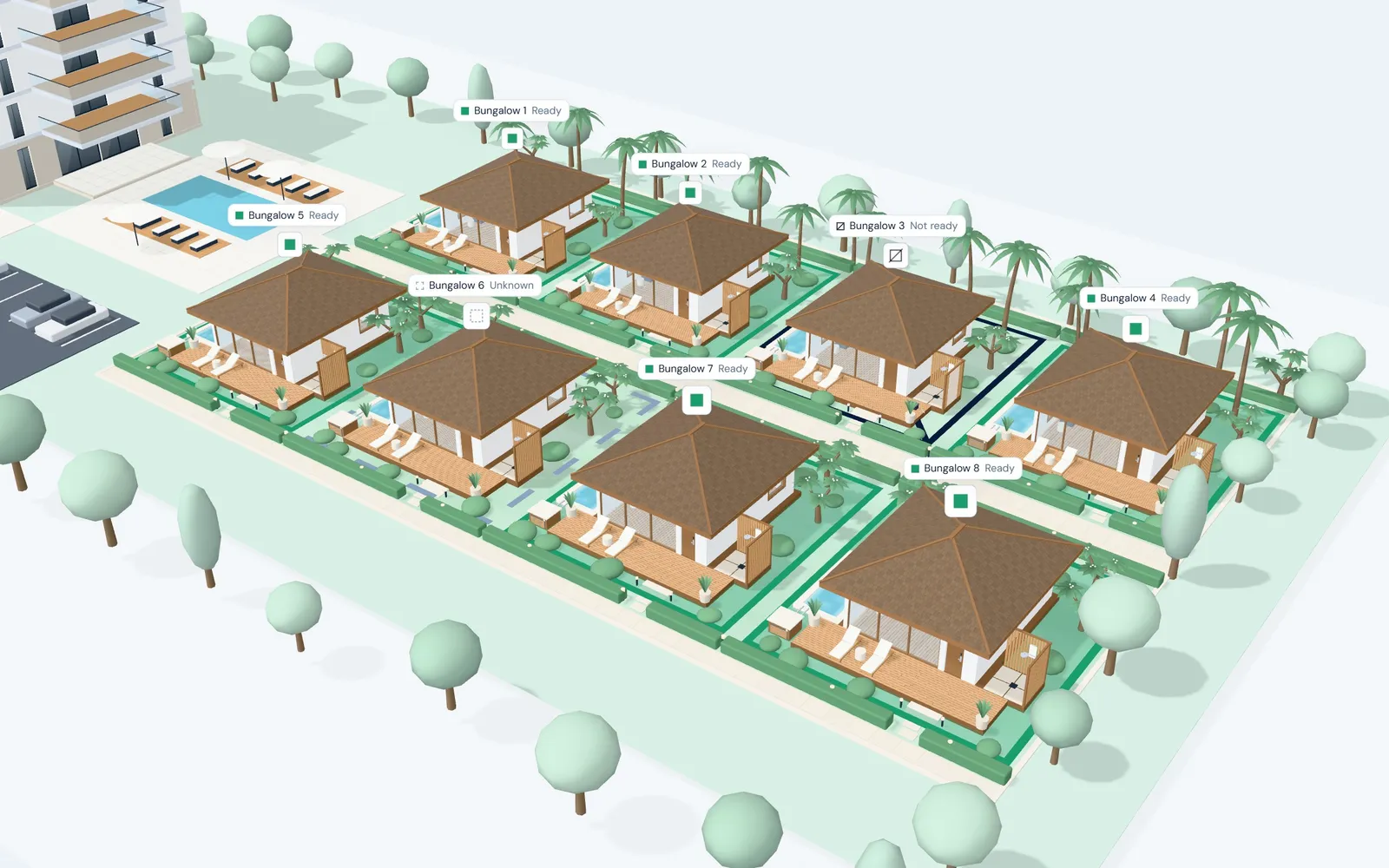

    The 8 garden bungalows in 3D, each labeled with its state. Bungalow 3 is Not ready and Bungalow 6 is Unknown, and the other 6 are Ready.
  10. 10 / Done is not ready

    Every team finished, and the bungalow is still not ready

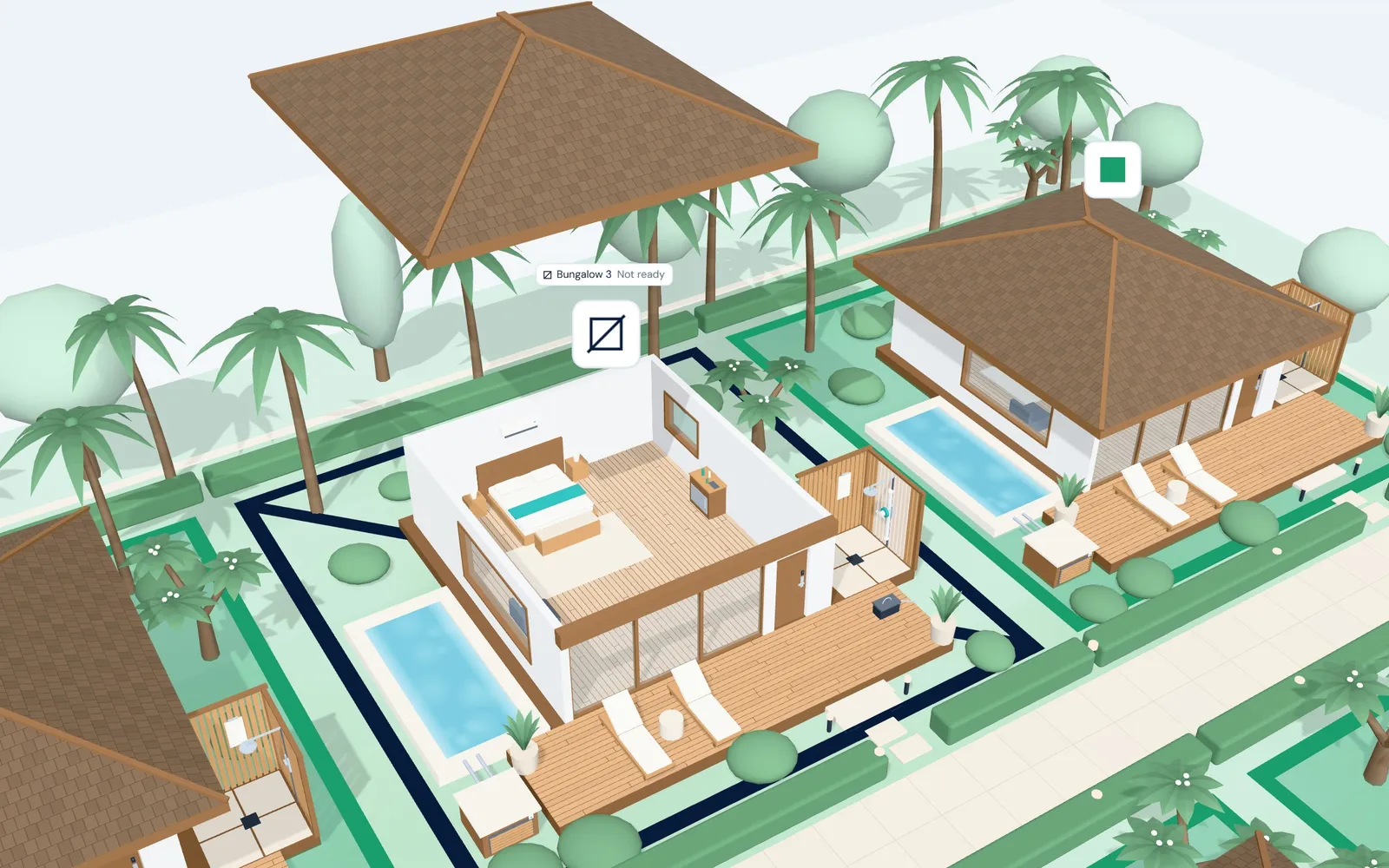

    Housekeeping cleaned and inspected Bungalow 3 by 06:36, and maintenance closed a repair on its outdoor shower at 06:50. Every task is done, yet the bungalow is not ready: the repair came after the inspection, so the inspection no longer covers it. The check at 07:00 names the gap, and the engine raises the inspection to housekeeping at 07:02. It is the pattern SuperAssets started from: finished work that still leaves a bungalow short of the standard.

    Bungalow 3 in 3D with one label marking it Not ready.
  11. 11 / Unknown

    No water test today: unknown

    Bungalow 6 has no plunge pool water test on record today, and that requirement is blocking. With no evidence the verdict is unknown, never a pass. Next step: Evidence needs review. No task created.

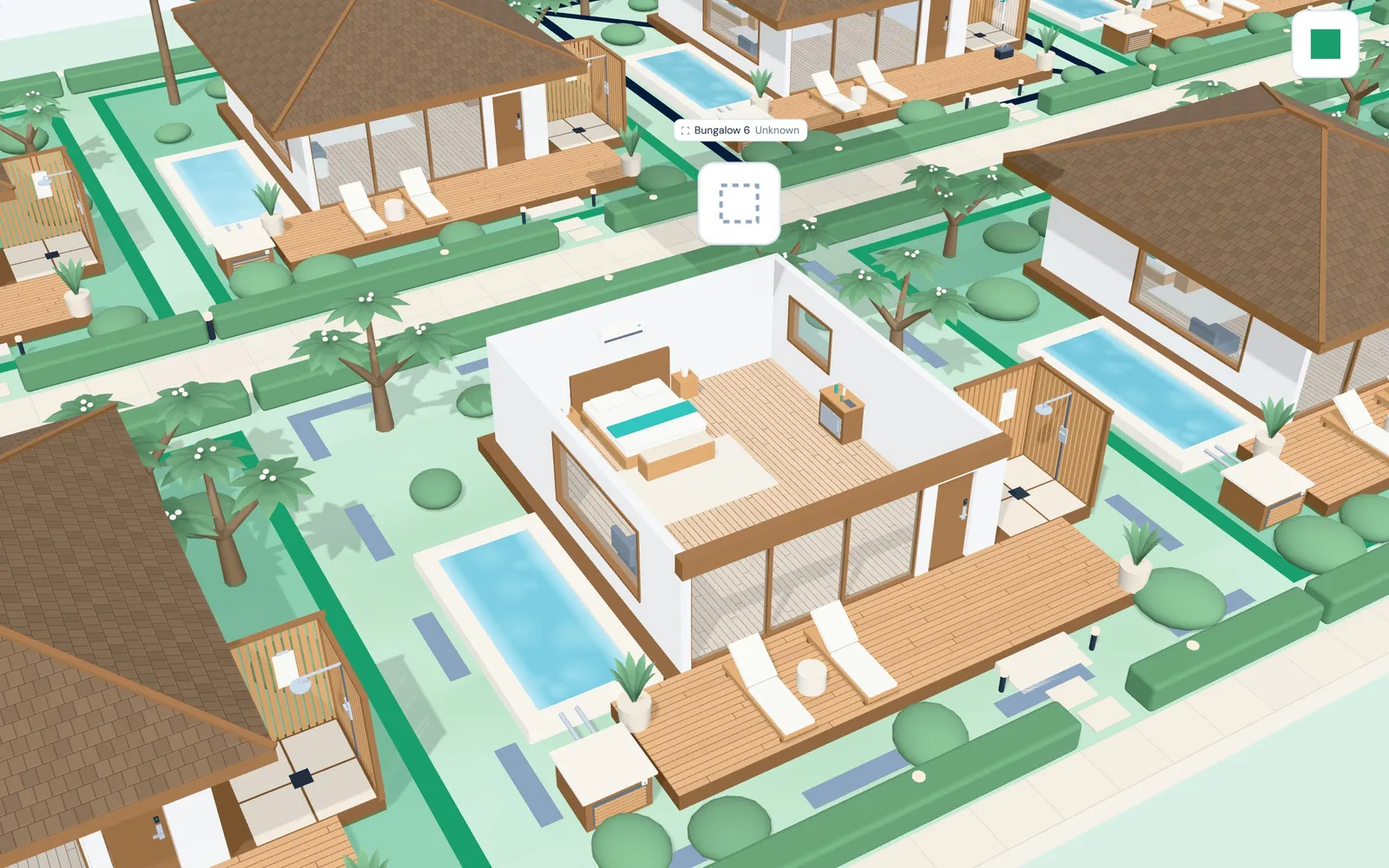

    Bungalow 6 in 3D with one label marking it Unknown.
  12. 12 / Summary

    A long standard becomes one state

    Floor 2 and the garden bungalows alone have 242 requirements to meet, each checked against its own evidence. You do not read them. You read one state per level, with its reason, and open the evidence only when you need it. The standard is written once, shared by every team, and no longer lives in one person’s head.

    Now see your own property

    Pick one room type, rack row or vehicle group. We map it from the records you already have and show you its readiness live. Free, no commitment.

    Get a free readiness snapshot Take the other tour

    The Superior Grand in 3D from above after the check ran again, with the hotel and its garden bungalows labeled by state.

Want this view of your own property? Get a free readiness snapshot →

In view

    See this for your own operation

    Ask for a free readiness snapshot: one room type, rack row or vehicle group, mapped from the records you already have, shown live.

    Get a free readiness snapshot
